First Principal Rates



First Principal Rates


First Principal Rates

Logic prevails

Science to some. Standard for us.

Science to some. Standard for us.


First-principles rates mean no guesswork. We construct each unit cost from first principles and evidence it with market supply rates and productivity that stands up to scrutiny.


Our first-principle build-ups expose the cost drivers for each component — material budgets, cartage costs, waste allowances, any fixing and material allowances, labour hours and margins.


Loosing jobs using 'book-rates' that you cant refine or talk to due to a lack of transparency?


Give us a call or email directly to see where the gaps in your rates are.

The principal stays the same.
Exactly.

  1. Rate Inputs

We need your company material supply rates, any agreed cartage costs and labour charge out rate. We look at the project scope of work to determine waste, plus any other access, fixings or sundry items that are required.

Custom PDF graphic icons with outlook icon by SubsQS Ltd
Custom PDF graphic icons with outlook icon by SubsQS Ltd

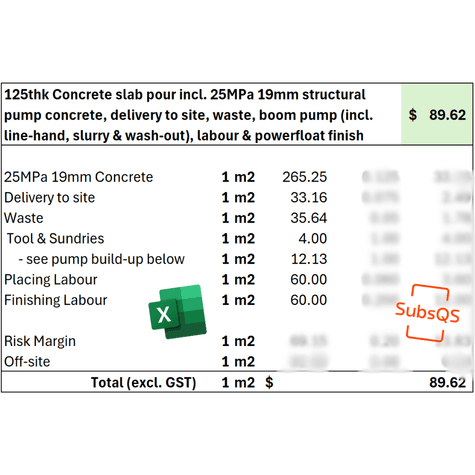

First principal rate buildup for concrete placing by SubsQS
First principal rate buildup for concrete placing by SubsQS
  1. Labour Component

  1. Labour

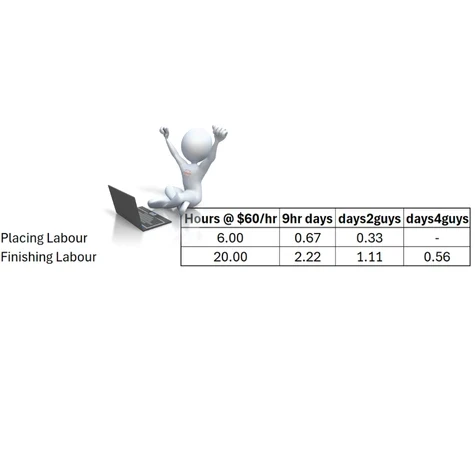

Depending on the rate being built, we can assign an industry average labour constant to begin, then refine that based on actual labour budget outcome to reflect your teams output for each unit rate line item.

  1. Margins

  1. Margins

We can include risk margins plus company off-site overheads within each rate. Alternatively, we can exclude margins from your commercially sensitive rates for you to assign prior to submission.

white chaaracter standing on orange blocks by SubsQS
white chaaracter standing on orange blocks by SubsQS
white character and spreadsheet table by SubsQS
white character and spreadsheet table by SubsQS
white character and spreadsheet table by SubsQS
  1. Total Budgets

  1. Total Budgets

With the rate now complete, send through the items quantity and unit of measure so we can extend each line item out into total budgets, including total labour hours, days, weeks etc.

  1. Excel Workbook

  1. Excel Book

Receive a copy of the workbook with all inputs and outputs for each rate. This makes updating the rate(s) due to a material or scope change super simple.

Green microsoft excel icon by SubsQS
Green microsoft excel icon by SubsQS
Green microsoft excel icon by SubsQS
Concept Stage estimate report by SubsQS Ltd
Concept Stage estimate report by SubsQS Ltd
Concept Stage estimate report by SubsQS Ltd
Concept Stage estimate report by SubsQS Ltd
  1. Covering Letter

We itemise all rate inclusions with their respective total budget based on your supplied quantity. Labour rates and total hours per unit are clarified along with any margins you provide to include.
